2023 Capital Improvement Project
About
Chatham Central School District is undertaking this project to improve our educational facilities and address issues with our aging infrastructure. Just like any property, schools need regular upkeep and infrastructure upgrades in order to serve the needs of our students and community effectively. The District’s buildings range in age from approximately 52 to 120 years old.
As a capital project, this work is eligible for 49.6% state aid. This significantly reduces the project’s impact on local property taxes. For every dollar the District spends it will get approximately 50 cents back in state building aid.
In February, 2023, residents approved a two-proposition referendum authorizing $22,098,195 in capital improvements for Chatham CSD's facilities.
Project Scope of Work*
Chatham High School
Base Scope
Replace entire building’s roof - completed phase 1
Replace gymnasium floor - phase 3
Replace gymnasium bleachers - phase 3
Replace gymnasium HVAC - completed phase 2
Renovate toilet rooms (excluding auditorium toilets) - ongoing
Modernize Science Classrooms (4) - completed phase 2
Relocate and upgrade Art Classrooms (2) - completed phase 2
Replace auditorium flooring (epoxy and carpet) - phase 3
Replace auditorium seating - phase 3
Replace classroom partition walls with permanent, secure, fire-rated walls - completed phase 1 & 2
Renovate band and choir rooms - phase 3
Exterior masonry repairs: replace stucco panels with metal panels - completed phase 1 & 2
Upgrade entrance lobby - ongoing
Redesign main building entrance with canopy - completed phase 1 & 2
Upgrade technology room/relocate tech computer lab adjacent to technology room - ongoing
Convert old tech computer lab to classroom - completed phase 2
Replace whole-building generator - completed phase 1
Repair curbing - completed phase 2
Install branding signage at rear of school on exterior gym wall - phase 3
Mill & repave parking lot - completed phase 2
Replace chain link fence between MED & CHS - completed phase 2
Alternate Scope
Install library doors to courtyard; convert courtyard to outdoor reading/classroom area - completed only in the event of leftover funds from Capital Project
Mary E. Dardess Elementary School
Base Scope
Install air conditioning - options currently being explored due to cost estimates coming in higher than amount approved by voters
*Unfavorable bidding conditions/cost increases did not allow for all items originally proposed for this project to be included in the final scope of work. As a result, District officials focused the majority of project work on Chatham High School, the building most in need of renovation, in order to keep the project within the maximum budget approved by voters.
Chatham High School






Existing Science, Art, Technology, and Band Room Conditions

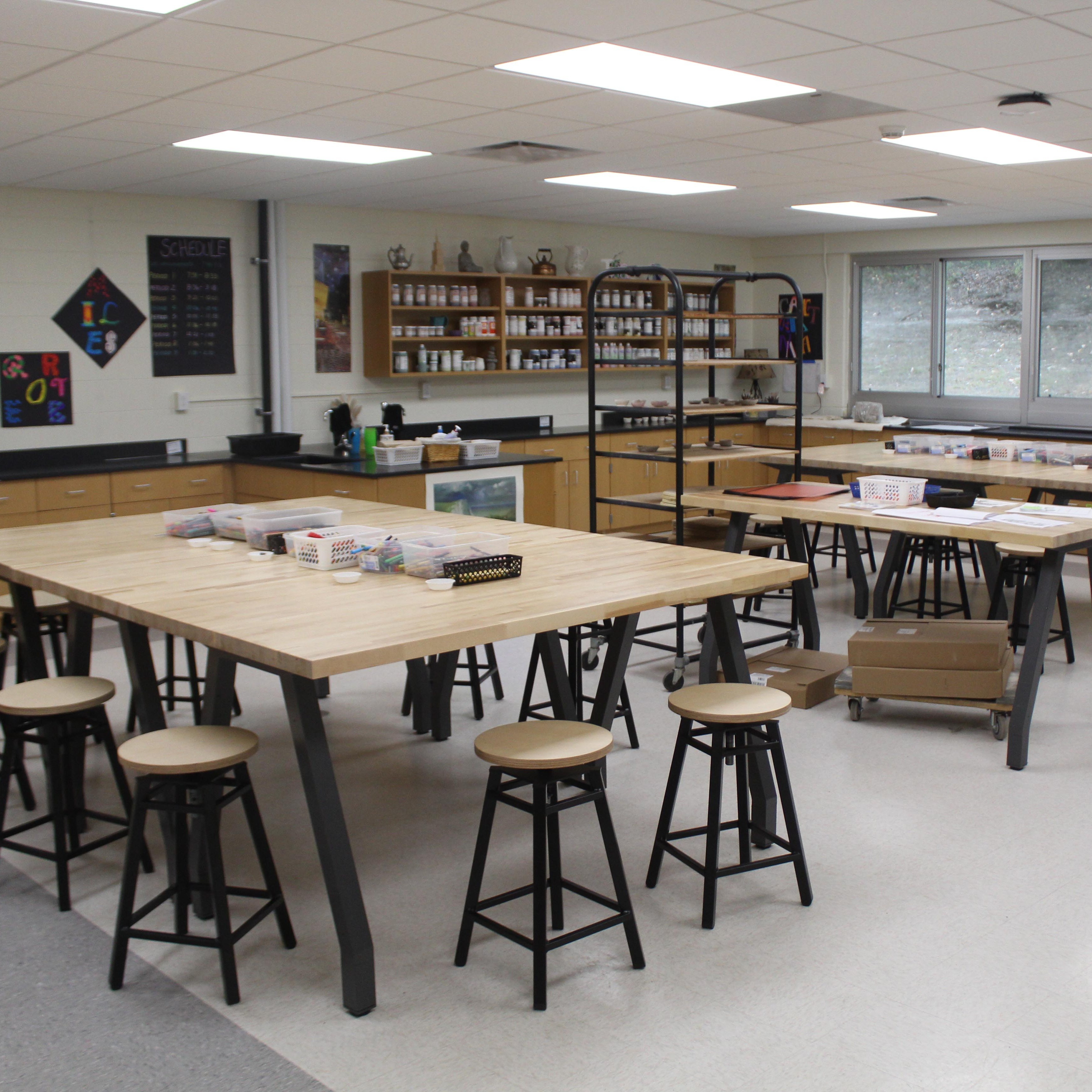

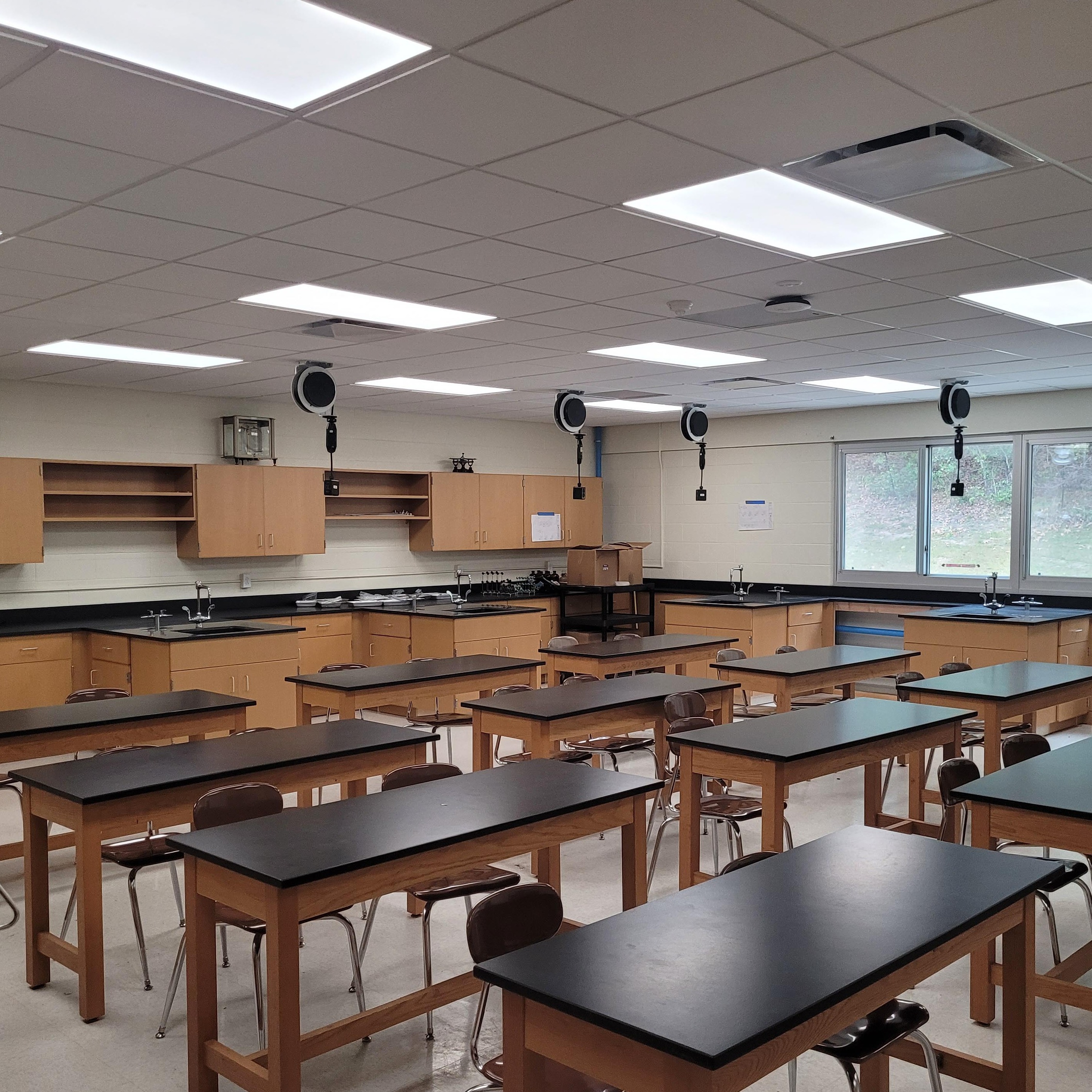

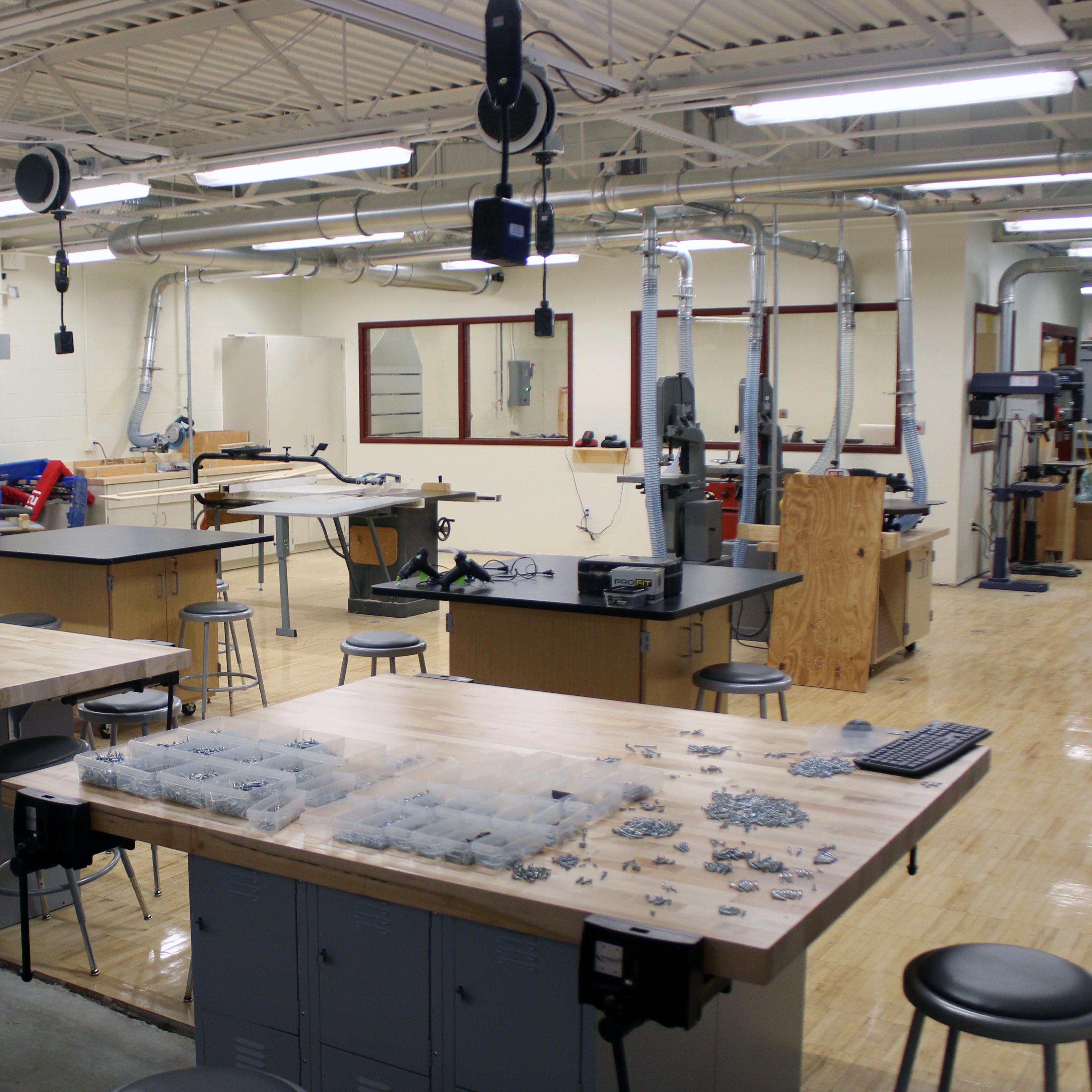

Sample Conceptual Science, Art, Technology, and Band Rooms




Conceptual Entrance & Lobby Renderings


Background
In December 2021, Chatham CSD completed a thorough review of our facilities needs, as part of the state-mandated Building Condition Survey that school's are required to complete every five years. It identified several areas that required attention due to their age and condition, or where renovating/updating certain spaces would allow those areas to better meet the needs of students and the larger school community.
On October 25, 2022, the District's Facilities Committee provided the Board of Education with a preliminary vision for the scope of the potential project. From this initial presentation, refined that vision to determine what improvements would be included in the Capital Improvement Project proposal that residents would be asked to decide on.
On November 28, Chatham Central School District held a public information session to inform residents about the proposed capital project being developed.
On December 13, the District's Facilities Committee presented their final recommendations and the Board of Education voted to approve the project proposal.
On Tuesday, February 14, 2023, residents approved propositions #1 and #2 in a public referendum.
